Once we got the approval, we just go with the plan. My contractor is working until late at night. There are many problems as we go along as plan is only good on paper, but most of the problem was already anticipated during the plan period. These unexacting changes of plan can make everyone easily lost control. That is why you need to choose your contractor carefully. Alhamdulillah, WAHISMA is very patient and have a high tolerance in dealing with it. I highly recommended them for any of your future renovation work. But they are not alone. They work with other contractors like aircond, carpentry, electrician, network, CCTV and dental supplier.
Hacking all the floor and wall takes 1 day, plumbing, CCTV and network 2 days, aircond installation about 2 weeks, wiring and fixing about 3 weeks, because they need to start early but finish their job after the ceiling and wall completed. One more things to consider is you need to get ready with all the material needed during each step. I think you need to get ready with the materials in the construction area at least 1 day ahead hu hu hu
My suggestion during this stage is you need to start with wiring, plumbing, and aircond at the same time and at the same speed. Your progress really depends on their speed before you can start with the next step, which is wall and ceiling. The aircond installation run a bit slow, it's kind of a dragging to slow down the other works.
Bear in mind, that you really need to be there at least once a day just because, you are the one who really knows your workspace and flow. You need to feel happy and comfortable with your new practise. The contractor don't have the same feeling with you and they will be gone the moment they hand over the unit to you for your next journey

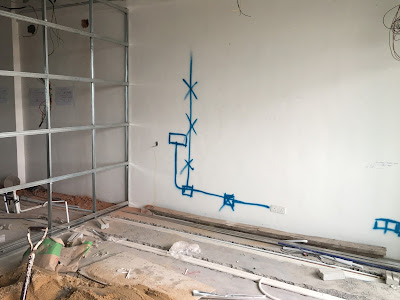

Plan carefully |

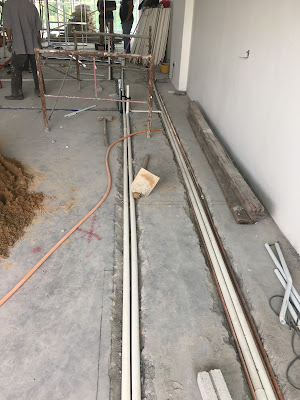

A bit tricky as the plumbing need to have a certain angle to let the water pass easily |
Future X-Ray room measurement must be exactly or bigger |
Surgery room |
